Introduction
On February 24th, 2025, Aztec engaged zkSecurity to perform an audit of its smart contract related to the Token Generation Event (TGE). The specific code to review was shared via GitHub as a private repository (https://github.com/AztecProtocol/teegeeee at commit 8432c82584731813a2197dd3b715ba2db0dbe3f9). The audit lasted 3 workdays with 1 consultant.
The code was found to be clear, well documented, and accompanied with thorough tests.
One major finding and a few informational findings were reported to the Aztec team, which are detailed in the following sections.
Scope
The scope included the Solidity contract in the teegeeee repo. At a high level this included:
src/token, which is the AZTEC ERC20 token contract.
src/atps, which is Aztec Token Positions (ATPs), including Milestone Aztec Token Position (MATP) and Linear Aztec Token Position (LATP).
src/libraries, which contains the helper for the schedule lock.
src/staker, which is the staker contract for AZTEC token. Currently, it’s just a “no-op” contract and is used for testing.
src/ATPFactory.sol, which is the factory to create new ATPs.
src/Registry.sol, which manages the global unlock schedule, staker implementations, and milestones.
Overview
The AZTEC token is an ERC20 token that is mintable by the contract owner. Aztec uses the Aztec Token Positions (ATPs) to distribute the AZTEC token to beneficiaries (e.g., individuals and companies). Each ATP is a standalone contract that holds the tokens to be distributed and specifies the unlock schedule. Typically, the unlock schedule is controlled by two schedules: the global unlock schedule (shared by every ATP) and the local unlock schedule specified by each ATP. At any given time the released token amount is the minimum of the two schedules. For example, if at the 12th month the local schedule releases 20% and the global schedule releases 10%, then the actual release is 10% (min(20%, 10%)). This means that all the ATPs are restricted by the global unlock schedule.

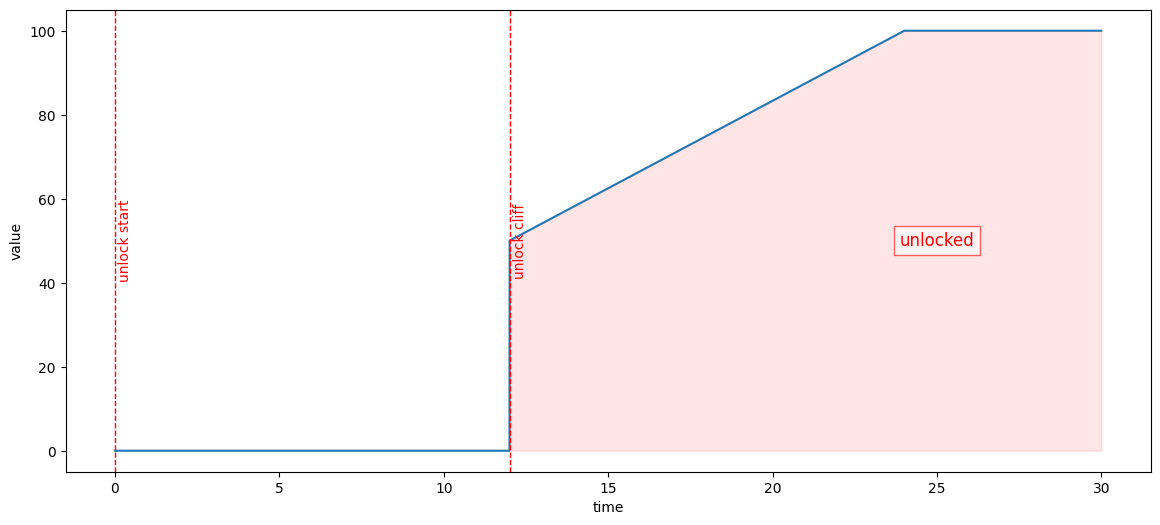

The global unlock schedule is a linear release curve with a cliff. The token is released linearly over time but only claimable after a specific cliff time. The curve is specified by a starting time, cliff time and end time. Below is an example schedule (taken from the docs of the repo) with a 24 month full duration and a 12 month cliff.

The local unlock schedule has two types: Milestone Aztec Token Position (MATP) and Linear Aztec Token Position (LATP).

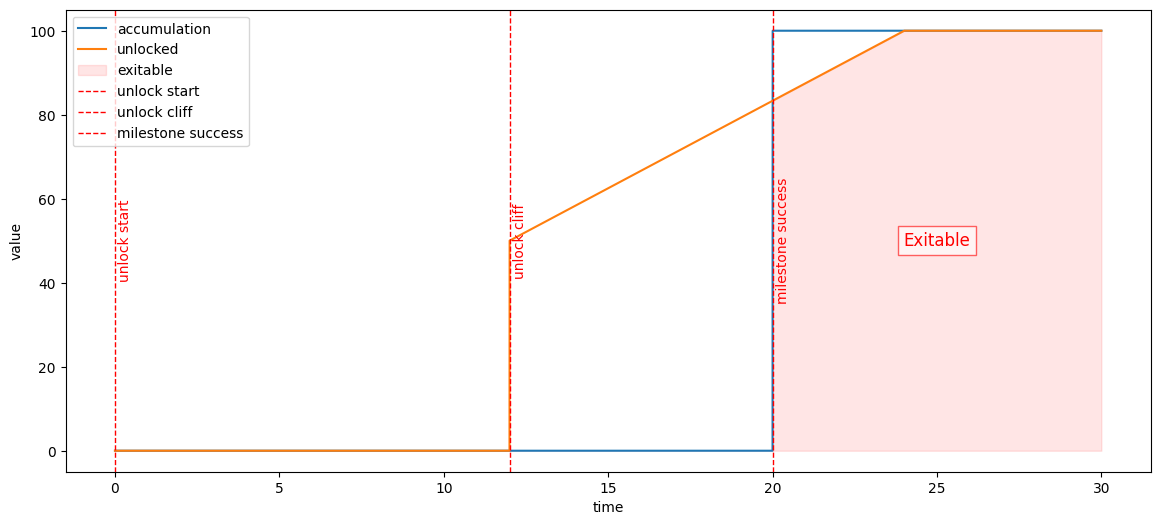

The unlock schedule of MATP is specified by a milestone. The token is released only after the milestone (e.g., mainnet launch) is achieved. Before that, all the tokens are locked. Below is an example schedule of the MATP (taken from the docs of the repo). In the example, the tokens are not released after the global unlock cliff but after the milestone success.

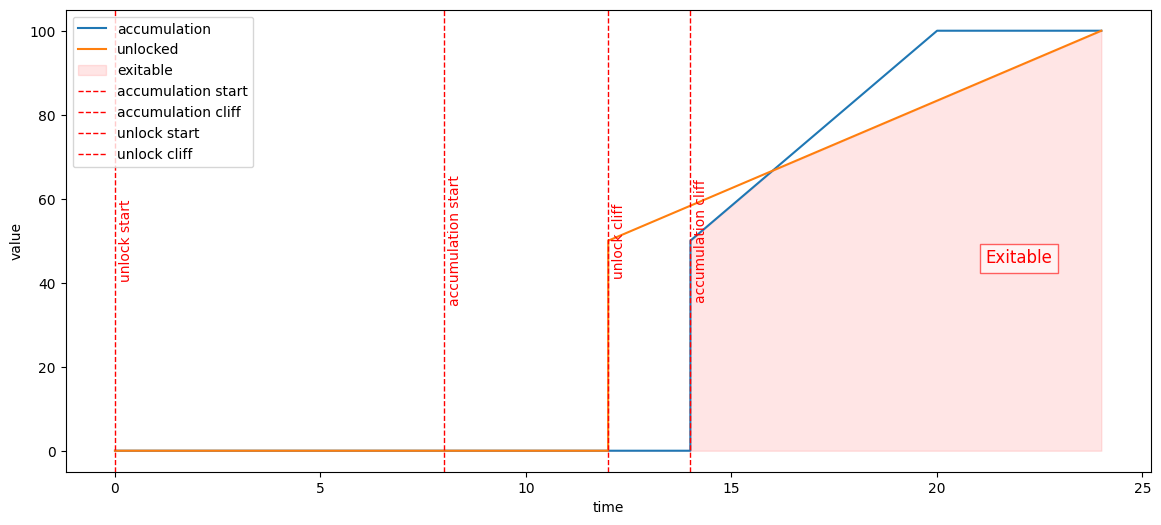

The unlock schedule of LATP is a linear release curve with a cliff (just like the global unlock schedule). The resulting unlock amount at a time is the minimum of the global unlock schedule and the local unlock schedule. Below is an example schedule of the MATP (taken from the docs of the repo). In the example, the tokens are released only after the two unlock cliffs are reached.

Staking and Revoking
In the Aztec network, the locked AZTEC token in ATP can participate in staking (to the sequencer). This is achieved by allowing the ATP contract to approve the locked token to the staker contract. The staker can then transfer the token from ATP, perform staking, and transfer the token back when necessary. It is important that the staking operation cannot be used to bypass the unlock schedule. Thus, the ATP can only use the staker contract that is specified by the Aztec-labs. More specifically, each ATP has its own staker contract. The staker contract implementation is whitelisted by the Registry, which is managed by the Aztec-labs.
For some ATP, the tokens can be revoked by a revoker entity if they have not been accumulated.
For MATP, all the tokens can be revoked by the revoker when the milestone is in Pending status (i.e., not Failed or Succeeded). If the milestone is Succeeded, then it can’t be revoked and all the tokens will eventually go to the beneficiary (the schedule is still restricted by the global lock). If the milestone is marked as Failed, then it means the MATP is fully revoked.
For LATP, there are two cases. It can be set as non-revokable. In this case the local schedule lock is empty and the schedule just follows the global schedule. If it is set as revokable, then it will have a local schedule. The token that is not released according to the local schedule lock is revokable by the revoker. The contract ensures that the revokable portion cannot be transferred to the staker.
Registry
The registry holds the “source of truth” data of the protocol. It consists of three main parts:
- Global Schedule. This specifies the global schedule. All ATPs will refer to the registry to get the global schedule. The registry owner can decrease the start time of the global schedule.
- Staker Implementation. This contains the implementation address of the staker. When necessary, the registry owner can add new version staker implementations.
- Milestone. The registry manages all the milestones. The registry owner can add a new milestone and update the status of it.
Below are listed the findings found during the engagement. High severity findings can be seen as
so-called
"priority 0" issues that need fixing (potentially urgently). Medium severity findings are most often
serious
findings that have less impact (or are harder to exploit) than high-severity findings. Low severity
findings
are most often exploitable in contrived scenarios, if at all, but still warrant reflection. Findings
marked
as informational are general comments that did not fit any of the other criteria.
Description. In the Aztec network, the locked AZTEC tokens in ATP can participate in staking. This is achieved by allowing the ATP contract to approve the locked token to the staker contract. It is crucial that the staking operation cannot be used to bypass the unlock schedule. In the contract, the ATP should be restricted to only use the staker contract that is whitelisted by the Registry. Unfortunately, due to an oversight, the ATP contract can use the upgradeStaker function to bypass the restriction and upgrade the staker contract to an arbitrary contract.
function upgradeStaker(StakerVersion _version, bytes memory _initdata)
external
override(IMATPCore)
onlyBeneficiary
{
address impl = REGISTRY.getMilestoneStakerImplementation(_version);
UUPSUpgradeable(address(staker)).upgradeToAndCall(impl, _initdata);
emit StakerUpgraded(_version);
}
In the upgradeStaker function above, the caller specifies the staker _version and _initdata. The staker implementation is then fetched from the global Registry. Then it will perform a UUPS upgrade for the staker and call the function specified in the _initdata. The _initdata is intended for initialization operations. However, there is no restriction on the _initdata, allowing the ATP to call arbitrary functions with arbitrary parameters during the upgrade. This includes calling the upgradeToAndCall function again.
To perform the attack, the ATP contract will encode the upgradeToAndCall function in the _initdata. Calling the upgradeStaker function then leads to two upgrades. The first upgrade has the implementation address checked. However, the second upgrade is embedded in upgradeToAndCall and is not checked. As a result, the ATP can upgrade the staker to an arbitrary implementation.
Below is a PoC of the attack:
// Add this test in test/btt/atps/milestone/upgradeStaker/upgradeStaker.t.sol
function test_arbitraryUpgrade() external {
address initialStaker = registry.getMilestoneStakerImplementation(StakerVersion.wrap(0));
FakeMilestoneStaker badStaker = new FakeMilestoneStaker(staking);
// encode the UUPSUpgradeable.upgradeToAndCall function with badStaker in the _initdata
atp.upgradeStaker(StakerVersion.wrap(0), abi.encodeCall(UUPSUpgradeable.upgradeToAndCall, (address(badStaker), "")));
assertEq(atp.getStaker().getImplementation(), address(badStaker));
assertNotEq(address(badStaker), initialStaker);
}
Impact. The ATP beneficiary can exploit this vulnerability to upgrade the staker to malicious implementation and then withdraw the locked token from the staker.
Recommendation. It is implicit that the ATP contract can call any function of the staker contract though the upgradeStaker function. To mitigate this, it is recommended to add a restriction to the _initdata in the function. For example, only allow calling the initialize function in the _initdata.
Description. The LockLib contains helper functions to handle the schedule lock. The createLock function creates a lock based on the provided parameters:
function createLock(LockParams memory _params, uint256 _allocation) internal pure returns (Lock memory) {
LockLib.assertValid(_params);
return Lock({
startTime: _params.startTime,
cliff: _params.startTime + _params.cliffDuration,
endTime: _params.startTime + _params.lockDuration,
allocation: _allocation
});
}
The cliff time and end time are calculated as the sum of the start time and the duration. The sum could overflow the range of uint256 if the time and duration are large numbers.
Additionally, in the claim function of ATP contract, the total claimed amount is updated by adding the current claimed amount. This could cause overflow if the amount is very large and the beneficiary cyclically claims and transfers tokens (since additional transferred token can be claimed).
function claim() external override(IMATPCore) onlyBeneficiary returns (uint256) {
uint256 amount = getClaimable();
require(amount > 0, NoClaimable());
claimed += amount;
TOKEN.safeTransfer(msg.sender, amount);
emit Claimed(amount);
return amount;
}
Impact. This is unlikely to cause issues in practice, as such overflows are improbable in real-world scenarios.
Recommendation. It is recommended to use SafeMath for arithmetic operations to prevent potential overflow and underflow.
